Introduction
The Capacity View shows, for every resource group and user, how much work is planned (load) compared with how much time is available (capacity). Each period is shown as a colored cell, so you can see at a glance where people are overloaded, where there is free time, and which projects cause the load.
Capacity View is available in two places:
- Pipeline – in the Future load panel under the project Gantt chart (Screen #1).
- Group Task List – in the Future load graph panel under the task list (Screen #2).

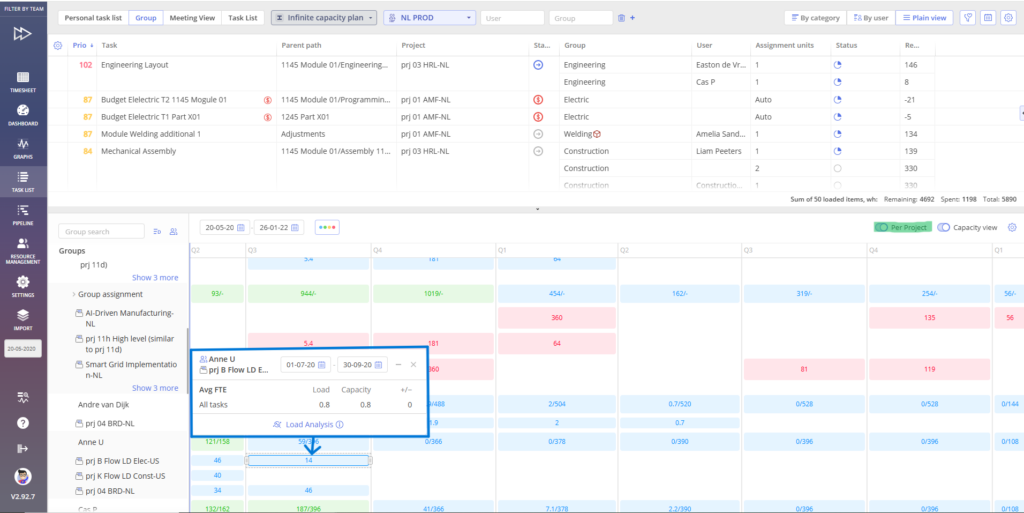

Screen #1 – Capacity View in Pipeline

Screen #2 – Capacity View in Group Task List
How to turn on Capacity View
In Pipeline
- Open Pipeline.
- If the panel under the Gantt chart is closed, click Future load (bottom-left, next to Cash flow) to open it.
- Switch on the Capacity view toggle in the top-right corner of the panel. The graph changes into a table of colored cells (Screen #1).
In Group Task List
- Open Task List and select the Group tab.
- Click the gear icon in the top-right corner.
- Under Sections, tick Future load graph (Screen #3).
- Switch on the Capacity view toggle in the top-right corner of the Future load panel.

Screen #3 – Sections menu in Group Task List
How to read a cell
- A group or user cell shows load/capacity in work hours. For example, 329/204 means 329 hours of work are planned, but only 204 hours are available.
- A project cell (see Capacity View per Project) shows load only, because projects have no capacity of their own.
- 0/- means the group has no capacity of its own (for example, a group that only receives group assignments).
- If project names are switched on, a cell lists the projects that cause the most load. A counter like 5+ shows how many more projects are in that cell.
Cell colors
Each color describes the whole group or user for that period:
- Blue – Underload: the planned load is lower than the available capacity, so the resource still has free time.
- Green – Optimal workload: the load fits the available capacity.
- Orange – Group-related overload: at least one user in the group belongs to two or more groups and is short of capacity in this group, but has free capacity in another group that can be borrowed.
- Red – Overload: the planned work is higher than the available capacity.
- Grey: there is no load and no capacity (for example, weekends in the Days view).
Dot indicators
A small orange or red dot in the top-right corner of a cell gives extra information about users who belong to more than one group.
Whether the dots describe a group or a single user depends on which list is open – the Groups list or the Users list. Switch between them with the people icon next to the search field (see Screen #11).
- Group level (Groups list)
- Orange: one of the users is overloaded, but can borrow capacity from another group.
- Red: some users in the group are overloaded, although the total group load is still lower than the group capacity.
- User level (Users list)
- Orange: the user is overloaded in this group, but their total load across all their groups is within their overall capacity.
- Red: the user is overloaded in at least one of their groups.
Show only certain colors
- Click the colored dots button at the top of the panel (Screen #4).
- Untick a color (Underload, Optimal workload, Group-related overload or Overload). Cells of that color are faded out, so the remaining ones stand out.
- Tick the color again to bring the cells back.

Screen #4 – Color filter
Choose what the cells show
- Click the gear icon in the top-right corner of the Future load panel (Screen #5).
- Under Project details, select one option:
- Only load/capacity – numbers only.
- Project name – numbers plus the project names. Click the arrow to choose Full name or Short name.
- Project attribute – numbers plus the value of a project attribute. Click the arrow to choose the attribute.

Screen #5 – Project details settings
Capacity View per Project
By default, the view shows one row per group and user (Screen #6). With Per Project switched on, each group and user also gets one row per project, so you can see how much each project adds to their load (Screen #2).
- Switch on the Per Project toggle next to Capacity view.
- Under each group or user, the projects with load are listed in separate rows. Each project row shows load only (projects have no capacity of their own).
- Click Show N more to see more project rows. Click Show less to hide them again.

Screen #6 – Capacity View with Per Project switched off
This view helps you find:
- which projects use the most capacity;
- which project causes an overload in a specific period;
- where work can be moved between projects.
Analyse the load of a cell
Group or user cell
- Click a group or user cell.
- A pop-up opens with the selected period and the average Load, Capacity and difference (+/-) in FTE.
- Change the period with the date fields if needed.
- Click Load Analysis to see the tasks behind the load, or Inactive Analysis to check the load that comes from inactive projects.
Project cell
Load Analysis is also available for a single project inside a group or user (Per Project must be on).
- Click a project cell. The pop-up shows the group or user and the project name, and the average project Load (Screen #7).
- Click Load Analysis.
- The view is filtered to this project, this group or user and this period. Only the tasks that cause this load are shown (Screen #8).
- Click Exit Load Analysis in the top-left corner to go back.

Screen #7 – Pop-up for a project cell

Screen #8 – Load Analysis for one project
Change the width of the names column
Long group, user or project names can be cut off. You can make the names column wider (Screen #9).
- Point at the border between the names column and the cells. A blue line appears.
- Drag the line to the right to make the column wider, or to the left to make it narrower.
The new width is kept after you refresh the page. In Pipeline, the names column and the project table above it change width together.

Screen #9 – Changing the names column width
Change the time unit
You can show the cells by Days, Weeks or Months (in Pipeline, larger units such as Quarters are also available, depending on the Gantt zoom level).
In Group Task List
You do not need to turn on the Timeline to change the time unit.
- Make sure Timeline is unticked in the gear menu (Screen #3).
- Click the time unit list next to the dates in the Future load panel.
- Select Days, Weeks or Months (Screen #10).

Screen #10 – Selecting the time unit in Group Task List
In Pipeline
In Pipeline the time unit follows the Gantt chart, so the Gantt chart and the Capacity View always use the same time unit. Use the time-unit list in the top-right corner of the Gantt chart to change it. The units offered depend on the current zoom level of the Gantt – for example Days and Weeks when you are zoomed in, and Months or Quarters when you are zoomed out.
Sort the list and switch between groups and users
- Click the sort icon next to the search field and choose Default order, Alphabetically, Average overload, Average underload or Peak load. Switch on Hierarchy only to keep the group structure while sorting.
- Click the people icon next to the sort icon to switch between the Groups list and the Users list (Screen #11).
- Type in the search field to find a group or user.

Screen #11 – Users list in Capacity View
Choose which projects count (Pipeline only)
- Click the pipeline list at the top of the Future load panel (Screen #12).
- Under Load based on, select:
- Total company pipeline – load from all projects;
- Filtered only – load only from the projects that match your current Pipeline filters.
- Tick Add shown inactive to also count the inactive projects shown in Pipeline.

Screen #12 – Load based on settings
Your settings (Capacity view, Per Project, project details and column width) are kept after you refresh the page.
You may also be interested in the Group Task List and Workload Analysis articles. If you have questions, contact us at support@epicflow.com.
